Appointing Your Party Wall Surveyor: Step-by-Step Guide to Avoid Delays in 2026 Projects

Nearly 40% of construction projects in London experience delays directly attributable to party wall disputes—delays that cost building owners an average of £3,500 in extended contractor fees and lost time. As 2026 brings unprecedented demand for residential renovations, EV charging infrastructure installations, and net-zero retrofits, understanding how to appoint the right party wall surveyor has become a critical skill for property owners. Appointing Your Party Wall Surveyor: Step-by-Step Guide to Avoid Delays in 2026 Projects provides the comprehensive roadmap needed to navigate this complex process efficiently and cost-effectively.

The party wall surveyor appointment process can seem daunting, particularly when project timelines are tight and neighbor relations are already strained. However, with the right knowledge and systematic approach, property owners can secure qualified surveyors quickly, minimize costs, and keep construction schedules on track.

Professional () hero image featuring 'Appointing Your Party Wall Surveyor: Step-by-Step Guide to Avoid Delays in 2026

Key Takeaways

  • Two appointment routes exist: Choose between an Agreed Surveyor (single impartial professional serving both parties) or separate surveyors for each owner, with costs averaging £1,000 for a complete Party Wall Award in 2026[1]
  • Ten-day appointment window is critical: Once a dispute arises, both parties should appoint their surveyor within ten days to prevent project delays[1]
  • Independence is non-negotiable: The party wall surveyor must be completely separate from any surveyor conducting your building works to maintain impartiality[1]
  • Schedule of condition documentation protects all parties: Professional photographic records establish baseline property conditions before work begins, preventing future disputes[1]
  • Building owner bears costs: The property owner carrying out works is legally responsible for surveyor fees, even when using an Agreed Surveyor arrangement[1]

Understanding When You Need to Appoint a Party Wall Surveyor

Before diving into the appointment process, property owners must first recognize which projects trigger party wall requirements. The Party Wall etc. Act 1996 applies to specific types of work affecting shared structures or boundaries between properties.

Notifiable Works Under the Party Wall Act

Building works requiring party wall procedures include:

  • Structural alterations to existing party walls – cutting into walls for beams, removing chimney breasts, or inserting damp-proof courses
  • New walls built on boundary lines – constructing walls directly on the property line between adjoining lands
  • Excavations within designated distances – digging within three meters of a neighbor's structure if going deeper than their foundations, or within six meters if excavating below a 45-degree plane from the bottom of their foundations[2]
  • EV charging infrastructure installations – wall-mounted charging units requiring electrical work through party walls, a growing category in 2026[5]

Understanding these triggers helps property owners recognize when the appointment process becomes necessary. Many homeowners mistakenly believe party wall procedures only apply to major structural projects, but even relatively minor works can fall within the Act's scope.

When Surveyor Appointment Becomes Necessary

Not every party wall notice automatically requires surveyor involvement. If your neighbor provides written consent to your party wall notice within 14 days, no surveyor appointment is necessary, and work can proceed according to your plans[1]. This represents the ideal scenario for both time and cost efficiency.

However, surveyor appointment becomes essential when:

✅ Your neighbor dissents (formally disagrees) with your party wall notice
✅ Your neighbor fails to respond within the 14-day statutory period (silence equals dissent)
✅ Your neighbor requests specific protective measures or conditions
✅ Either party wants professional documentation through a schedule of condition despite consent

Even when neighbors consent, many experienced property owners opt for a condition survey to establish baseline documentation. This proactive approach costs significantly less than resolving post-construction damage disputes.

Appointing Your Party Wall Surveyor: Step-by-Step Guide to Avoid Delays in 2026 Projects – The Two Routes

The Party Wall Act provides two distinct pathways for surveyor appointment, each with different cost implications, timelines, and procedural requirements. Understanding these routes enables property owners to make informed decisions that align with their project needs and neighbor relationships.

Detailed () image showing close-up of professional surveyor's hands holding official Party Wall Notice document with visible

Route 1: The Agreed Surveyor Approach (Recommended)

The Agreed Surveyor route involves both property owners jointly appointing a single impartial surveyor who acts fairly for both parties. This approach offers several compelling advantages:

Benefits of the Agreed Surveyor Route:

  • 💰 Lower costs – Single surveyor fee typically around £1,000 for a complete Party Wall Award[1]
  • ⏱️ Faster timeline – Streamlined decision-making without coordination between multiple surveyors
  • 🤝 Simplified communication – One point of contact for all parties
  • 📋 Reduced complexity – Single Award document rather than coordinated agreements

The Agreed Surveyor must maintain complete impartiality, acting in the interests of both building owner and adjoining owner equally. This professional cannot be the same surveyor conducting your architectural or structural engineering work—neighbors are unlikely to view such an arrangement as truly independent[1].

Agreed Surveyor Appointment Process:

  1. Propose a qualified surveyor to your neighbor within your party wall notice or subsequent correspondence
  2. Obtain written agreement from your neighbor confirming acceptance of the proposed surveyor
  3. Formalize the appointment with written confirmation to the surveyor from both parties
  4. Provide project documentation including architectural drawings, structural calculations, and construction methodology
  5. Facilitate property access for the surveyor to conduct condition surveys of both properties

For property owners in specific London areas, finding qualified professionals is straightforward through specialized services. Whether you're located in East London, North London, or South London, regional expertise ensures surveyors understand local construction practices and property characteristics.

Route 2: Separate Surveyors with Third Surveyor Selection

When parties cannot agree on a single surveyor—or when relationships are particularly contentious—each owner appoints their own surveyor. These two appointed surveyors then jointly select a Third Surveyor who serves as a dispute resolution mechanism if the two surveyors cannot reach agreement[2].

Characteristics of the Separate Surveyor Route:

  • 💷 Higher costs – Two surveyor fees plus potential Third Surveyor involvement (£1,500-£3,000 total)
  • 📅 Extended timeline – Additional coordination required between surveyors
  • 🛡️ Individual representation – Each party has dedicated professional advocacy
  • ⚖️ Built-in dispute resolution – Third Surveyor provides binding decisions if needed

Separate Surveyor Appointment Timeline:

Stage Timeframe Action Required
Notice served Day 0 Building owner serves party wall notice
Response period Days 1-14 Adjoining owner responds or dissents
Surveyor appointment Days 15-24 Each party appoints surveyor (within 10 days of dispute)[1]
Third Surveyor selection Days 25-35 Appointed surveyors jointly select Third Surveyor
Award preparation Days 36-56 Surveyors conduct inspections and draft Award
Award delivery Day 57+ Party Wall Award served on both parties

This timeline assumes no complications. Delays in any stage compound, potentially pushing project starts back by months. The ten-day appointment window after dispute is particularly critical—missing this deadline can add weeks to the overall process[1].

Essential Qualifications and Selection Criteria for Your Party Wall Surveyor

Not all surveyors possess equal expertise in party wall matters. Selecting a qualified professional with appropriate credentials, experience, and local knowledge directly impacts both the quality of the Award and the efficiency of the process.

Professional Qualifications to Verify

RICS Membership (Royal Institution of Chartered Surveyors)

The gold standard for party wall surveyors is RICS membership with specific party wall expertise. RICS members adhere to professional standards, maintain indemnity insurance, and follow ethical guidelines that protect property owners. In 2026, amid high demand for surveyor services driven by EV infrastructure projects and net-zero retrofits[5], RICS membership provides assurance of competency.

Look for surveyors with:

MRICS or FRICS designation – Member or Fellow status indicating established professional standing
Specific party wall experience – Demonstrated track record with Party Wall Act matters
Professional indemnity insurance – Minimum £1 million coverage (verify current policy)
Local practice area – Familiarity with regional building practices and property types

Experience Factors That Matter

Beyond formal qualifications, practical experience significantly influences surveyor effectiveness. When evaluating potential surveyors, consider:

Project-Specific Experience:

  • Has the surveyor handled similar work types (loft conversions, basement excavations, structural alterations)?
  • Does the surveyor understand the specific construction methodologies your project requires?
  • Has the surveyor worked with your property type (Victorian terraces, modern developments, conservation areas)?

Dispute Resolution Track Record:

  • How many Awards has the surveyor prepared in the past 12 months?
  • What is the surveyor's approach to contentious situations?
  • Can the surveyor provide references from both building owners and adjoining owners?

Communication and Responsiveness:

  • Does the surveyor respond promptly to initial inquiries?
  • Can the surveyor explain complex technical matters in accessible language?
  • What is the surveyor's typical timeline for Award preparation?

For projects in Central London or West London, surveyors with specific experience in these high-density areas understand the unique challenges of closely-spaced properties and conservation area requirements.

Red Flags to Avoid

Certain warning signs indicate a surveyor may not provide the professional service your project requires:

🚩 Surveyor is your architect or structural engineer – Lacks independence neighbors will accept[1]
🚩 Unusually low fees – Quality surveying requires time; rock-bottom prices suggest corners will be cut
🚩 No RICS membership – Lacks professional standards and accountability
🚩 Vague timeline commitments – Indicates overcommitment or disorganization
🚩 Dismissive of neighbor concerns – Will escalate rather than resolve disputes

"The appointed surveyor must demonstrate complete independence from the building owner's design team. Neighbors rightfully question impartiality when the same professional is both designing works and supposedly protecting adjoining owner interests." – RICS Party Wall Guidance

The Step-by-Step Appointment Process: Avoiding Common Delays

With qualification criteria understood, the practical appointment process requires careful attention to timing, documentation, and communication. Following this systematic approach minimizes delays and establishes a solid foundation for efficient Award preparation.

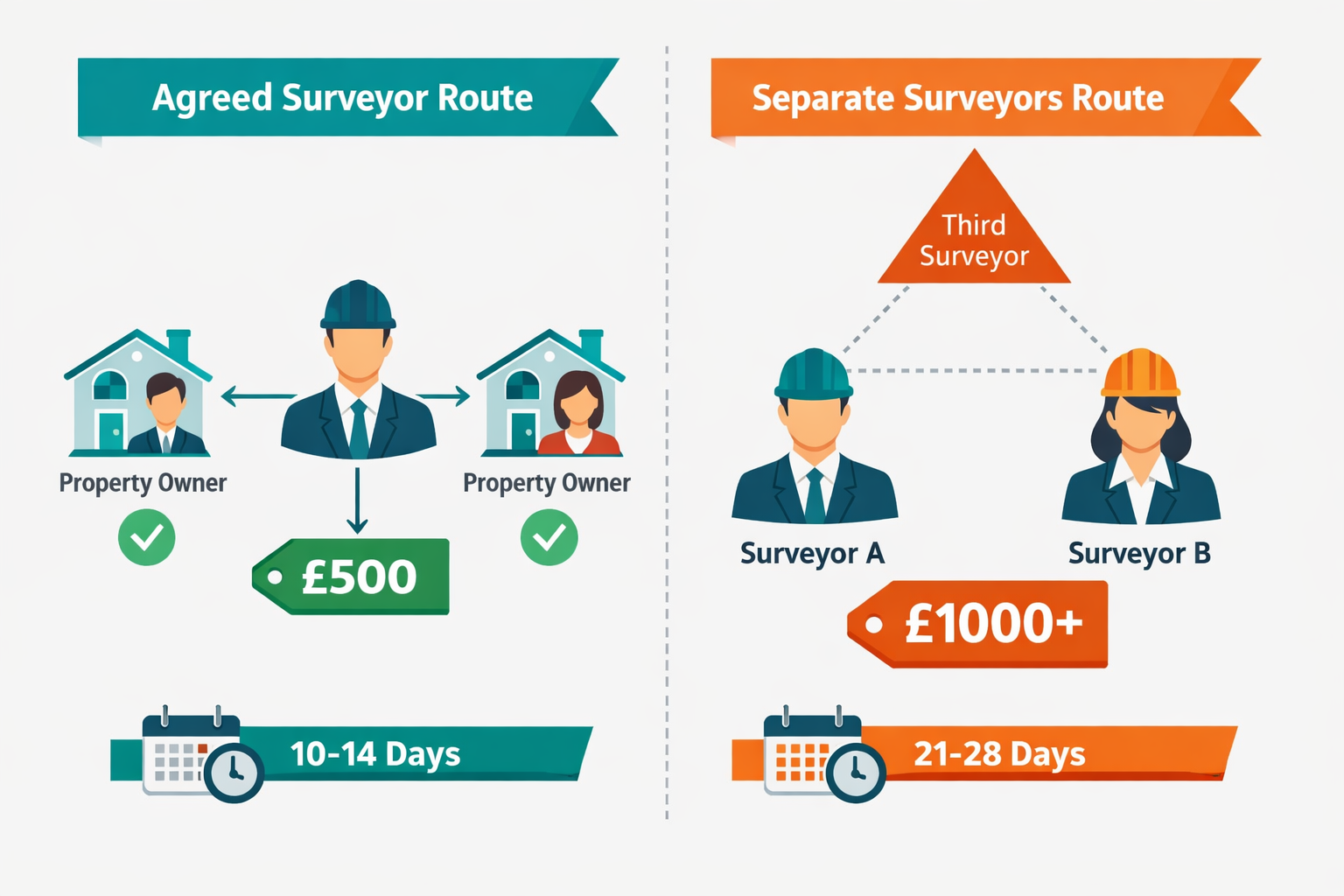

Comprehensive () infographic-style image displaying two distinct pathways: left side shows 'Agreed Surveyor Route' with

Step 1: Serve Proper Party Wall Notices (Before Surveyor Involvement)

Surveyor appointment only becomes relevant after proper party wall notices have been served. Many delays stem from defective notices that fail to meet statutory requirements. Your party wall notice must include:

  • Clear description of proposed works with sufficient detail for neighbors to understand impact
  • Drawings and plans showing the nature and extent of works
  • Proposed start date (at least two months for Party Structure Notices, one month for other notices)
  • Building owner contact information for responses
  • Statutory rights explanation informing neighbors of their options

Understanding what party wall notices are and how to respond helps building owners serve compliant notices that start the process correctly.

Step 2: Monitor the 14-Day Response Window

After serving your notice, your neighbor has 14 days to respond in one of three ways:

  1. Written consent – Work can proceed without surveyor involvement (though condition surveys remain advisable)
  2. Written dissent – Triggers the surveyor appointment process
  3. No response – Legally treated as dissent, requiring surveyor appointment[1]

Track this timeline carefully. Many building owners lose valuable days by waiting for responses that never arrive, not realizing that silence constitutes dissent.

Step 3: Initiate Surveyor Appointment Within Ten Days

Once dissent occurs (whether explicit or through silence), both parties should appoint their surveyor within ten days[1]. This tight timeline exists to prevent indefinite delays, but many property owners miss this window through:

  • Delayed recognition that silence equals dissent
  • Difficulty finding available qualified surveyors during peak periods
  • Uncertainty about the appointment process
  • Miscommunication with neighbors about appointment intentions

For Agreed Surveyor appointments:

  • Propose your selected surveyor to the neighbor immediately upon dissent
  • Provide the surveyor's credentials and contact information
  • Request written confirmation of acceptance
  • If the neighbor objects, be prepared to negotiate an alternative or switch to separate surveyor route

For Separate Surveyor appointments:

  • Notify your neighbor in writing of your appointed surveyor's name and contact details
  • Request your neighbor's surveyor information
  • Ensure both surveyors have each other's contact information
  • Confirm both surveyors will jointly select a Third Surveyor

Step 4: Formalize the Appointment in Writing

Verbal agreements hold no weight in party wall procedures. Formalize all appointments with written documentation that includes:

📄 Appointment letter contents:

  • Confirmation that the surveyor accepts the appointment
  • Acknowledgment of the surveyor's duties under the Party Wall Act
  • Fee structure and payment terms (hourly rates typically £150-£200 in 2026)[1]
  • Expected timeline for Award preparation
  • Contact information and availability

The building owner is responsible for paying surveyor fees even in Agreed Surveyor arrangements[1], so clear fee agreements prevent later disputes. For guidance on managing these expenses, see our article on how to keep party wall costs down.

Step 5: Provide Complete Project Documentation

Surveyors cannot prepare accurate Awards without comprehensive project information. Gather and provide:

  • Architectural drawings showing all proposed works
  • Structural calculations for beam insertions, wall removals, or foundation work
  • Construction methodology statements explaining how work will be executed
  • Project timeline with anticipated start and completion dates
  • Contractor information including insurance details

Incomplete documentation causes the most common delays in Award preparation. Surveyors cannot proceed until they fully understand proposed works and their potential impacts.

Step 6: Facilitate Property Access for Condition Surveys

The surveyor must conduct a thorough schedule of condition survey of the adjoining owner's property before works commence. This documentation establishes baseline conditions and prevents disputes about pre-existing versus construction-related damage[1].

Condition survey best practices:

  • Coordinate access times convenient for the adjoining owner
  • Ensure the surveyor has access to all relevant areas (not just rooms adjacent to party walls)
  • Request comprehensive photographic documentation
  • Verify that the schedule includes detailed descriptions of existing defects
  • Obtain copies of the condition survey for your records

Some neighbors resist property access, viewing it as intrusive. Professional surveyors skilled in communication can usually overcome these objections by explaining the protective benefits for the adjoining owner.

Understanding the Party Wall Award: What Your Surveyor Will Produce

Once appointed, the surveyor's primary deliverable is the Party Wall Award—a legally binding document that governs how works proceed[2]. Understanding Award contents helps building owners recognize quality surveying and ensures the document adequately protects all parties.

Standard Party Wall Award Components

A comprehensive Award typically includes:

1. Parties and Properties Identification

  • Full names and addresses of building owner and adjoining owner
  • Legal descriptions of properties involved
  • Details of appointed surveyor(s)

2. Description of Proposed Works

  • Detailed specification of works covered by the Award
  • Reference to architectural drawings and structural calculations
  • Clarification of any modifications to originally proposed works

3. Schedule of Condition

  • Comprehensive photographic record of adjoining property
  • Written descriptions of existing defects, cracks, or damage
  • Baseline documentation for post-construction comparison

4. Working Practices and Protective Measures

  • Required construction methodologies
  • Protective measures for adjoining property (shoring, temporary supports, etc.)
  • Noise and vibration limitations
  • Working hours restrictions

5. Access Arrangements

  • Rights of access to adjoining property if necessary
  • Notice requirements for access
  • Limitations on access extent and timing

6. Dispute Resolution Procedures

  • Process for addressing damage claims
  • Surveyor's ongoing role during construction
  • Procedures for Award variations if circumstances change

7. Cost Allocation

  • Responsibility for surveyor fees (typically building owner)[1]
  • Allocation of any shared costs
  • Payment timeline and terms

The Award serves as the contractual framework for works, providing clarity that prevents disputes and establishes accountability. For more details on Award structure, see our guide on party wall contract templates and Awards.

Timeline for Award Preparation

Award preparation timelines vary based on project complexity, surveyor workload, and party cooperation. Typical timelines in 2026:

  • Simple projects (single-story extensions, minor alterations): 2-3 weeks
  • Moderate complexity (loft conversions, basement excavations): 3-5 weeks
  • Complex projects (major structural alterations, multiple party walls): 5-8 weeks

High demand for surveyors in 2026, driven by EV infrastructure retrofits and net-zero compliance projects[5], has extended these timelines in some areas. Early surveyor appointment and complete documentation submission help minimize delays.

2026-Specific Considerations: EV Infrastructure and Net-Zero Compliance

The party wall landscape has evolved significantly in 2026, with new project types creating unprecedented demand for surveyor services. Understanding these emerging considerations helps property owners anticipate requirements and avoid delays.

EV Charging Infrastructure Party Wall Requirements

The installation of electric vehicle charging infrastructure has become a major driver of party wall activity in 2026. Wall-mounted charging units often require electrical work through party walls, triggering Party Wall Act procedures[5].

EV charging installations requiring party wall procedures:

  • External wall-mounted units requiring electrical conduits through party walls
  • Shared parking structure installations affecting party structures
  • Underground cable routing near neighbor foundations
  • Structural modifications for heavy-duty commercial charging equipment

Property owners planning EV charging installations should factor party wall procedures into project timelines, particularly in terraced housing and apartment buildings where party walls are common. The types of party wall works that trigger requirements continue to expand with evolving technology.

Net-Zero Retrofit Considerations

Government net-zero mandates have accelerated residential retrofit projects, many of which involve party wall implications:

  • External wall insulation on semi-detached and terraced properties
  • Heat pump installations requiring structural modifications
  • Solar panel mounting systems affecting roof party structures
  • Ventilation system installations penetrating party walls

These retrofit projects often catch property owners by surprise, as they may not initially recognize party wall implications. Consulting with qualified surveyors early in retrofit planning prevents costly delays when projects are already underway.

Common Pitfalls and How to Avoid Them

Even with careful planning, certain mistakes repeatedly cause delays and complications in surveyor appointments. Learning from these common errors helps property owners navigate the process smoothly.

Pitfall 1: Appointing Your Own Project Surveyor

The mistake: Using the same surveyor conducting your building project design or contract administration as your party wall surveyor.

Why it causes problems: Neighbors rightfully question this surveyor's impartiality, often refusing to accept them as an Agreed Surveyor[1]. This forces the separate surveyor route with higher costs and extended timelines.

The solution: Always appoint an independent party wall specialist separate from your design team. Maintain clear separation between project design and party wall compliance roles.

Pitfall 2: Ignoring the Ten-Day Appointment Window

The mistake: Delaying surveyor appointment beyond the ten-day window after dissent occurs[1].

Why it causes problems: Each day of delay compounds, pushing back Award preparation and construction start dates. Neighbors may perceive delays as lack of seriousness or professionalism.

The solution: Prepare a shortlist of qualified surveyors before serving party wall notices. When dissent occurs, contact surveyors immediately to check availability and initiate appointments.

Pitfall 3: Providing Incomplete Project Documentation

The mistake: Submitting preliminary drawings or vague work descriptions to the surveyor.

Why it causes problems: Surveyors cannot prepare accurate Awards without complete information. They must repeatedly request additional documentation, extending timelines significantly.

The solution: Wait until project design is finalized before appointing surveyors. Provide comprehensive documentation packages including detailed drawings, structural calculations, and construction methodology statements.

Pitfall 4: Neglecting Schedule of Condition Documentation

The mistake: Skipping condition surveys or accepting superficial documentation.

Why it causes problems: Without thorough baseline documentation, any post-construction damage claims become disputes about whether damage existed previously[1]. These disputes can cost thousands to resolve and damage neighbor relationships permanently.

The solution: Insist on comprehensive photographic schedules of condition covering all areas of the adjoining property, not just rooms immediately adjacent to party walls. Verify documentation quality before works commence.

Pitfall 5: Assuming Consent Means No Documentation Needed

The mistake: Proceeding with works immediately after neighbor consent without any condition survey.

Why it causes problems: Even with consent, construction can cause unexpected damage. Without baseline documentation, proving pre-existing conditions becomes impossible.

The solution: Even when neighbors consent, commission a professional condition survey. The modest cost (typically £300-£500) provides invaluable protection if disputes arise later. Some property owners choose to proceed with party wall agreements without surveyors, but this carries significant risk.

Cost Management Strategies for Surveyor Appointments

Party wall surveyor costs represent a necessary project expense, but property owners can employ strategies to manage these costs effectively while maintaining quality service.

Understanding 2026 Surveyor Fee Structures

Typical party wall surveyor costs in 2026 include[1]:

  • Hourly rates: £150-£200 per hour for qualified RICS surveyors
  • Fixed-fee Awards: £1,000-£1,500 for straightforward projects
  • Complex project fees: £2,000-£4,000 for major structural works
  • Separate surveyor arrangements: £1,500-£3,000 total (both surveyors plus potential Third Surveyor involvement)

The Agreed Surveyor route typically costs 30-40% less than separate surveyor arrangements, making it the preferred option when neighbor relationships permit.

Strategies to Minimize Surveyor Costs

💡 Choose the Agreed Surveyor route when possible – Single surveyor fees significantly reduce total costs[1]

💡 Provide complete documentation upfront – Reduces surveyor time spent requesting additional information

💡 Maintain professional neighbor communications – Prevents disputes that escalate costs

💡 Request fixed-fee quotes – Provides cost certainty compared to open-ended hourly arrangements

💡 Bundle multiple projects – If planning several works, coordinate party wall procedures to share surveyor costs

💡 Choose appropriately qualified surveyors – Overqualified surveyors charge premium rates for straightforward projects

For detailed cost management guidance, consult our comprehensive resource on party wall costs and the process.

Maintaining Professional Relationships Throughout the Process

Party wall procedures occur within the context of ongoing neighbor relationships. Professional conduct throughout the appointment and Award process preserves these relationships and facilitates smoother construction.

Communication Best Practices

With neighbors:

  • Provide advance informal notice of planned works before formal party wall notices
  • Explain the party wall process and what neighbors should expect
  • Respond promptly to neighbor questions and concerns
  • Keep neighbors informed of project timeline changes
  • Address complaints or issues immediately rather than allowing them to escalate

With surveyors:

  • Respond quickly to information requests
  • Facilitate property access as needed
  • Maintain professional tone in all communications
  • Respect surveyor independence and professional judgment
  • Pay invoices promptly according to agreed terms

With contractors:

  • Ensure contractors understand Award requirements and restrictions
  • Verify contractors maintain required insurance coverage
  • Monitor compliance with working hours and protective measures
  • Address any Award violations immediately
  • Document all construction activities affecting party walls

Handling Disputes Professionally

Despite best efforts, disputes sometimes arise during party wall processes. Professional dispute management includes:

  1. Document everything – Maintain written records of all communications and events
  2. Seek surveyor guidance – Leverage the surveyor's expertise in resolving technical disagreements
  3. Remain calm and professional – Emotional responses escalate conflicts
  4. Focus on facts and evidence – Base positions on documentation rather than assumptions
  5. Consider mediation – Professional mediation can resolve disputes more efficiently than formal proceedings

Understanding the Party Wall etc. Act 1996 framework helps all parties recognize their rights and obligations, reducing misunderstandings that lead to disputes.

Conclusion: Your Action Plan for Efficient Surveyor Appointment

Successfully appointing your party wall surveyor requires systematic planning, appropriate timing, and attention to qualification criteria. By following the step-by-step approach outlined in this guide, property owners can minimize delays, control costs, and establish the professional framework necessary for smooth construction in 2026.

Immediate Action Steps

Before serving party wall notices:

  • ✅ Research and shortlist 3-5 qualified RICS party wall surveyors in your area
  • ✅ Verify surveyor credentials, experience, and availability
  • ✅ Obtain preliminary fee quotes and timeline estimates
  • ✅ Finalize project documentation including detailed drawings and specifications

After serving notices:

  • ✅ Monitor the 14-day response period carefully
  • ✅ Recognize that neighbor silence equals dissent
  • ✅ Initiate surveyor appointment within ten days of dissent[1]
  • ✅ Formalize appointments with written confirmation
  • ✅ Provide complete project documentation to appointed surveyor(s)

During Award preparation:

  • ✅ Facilitate property access for condition surveys
  • ✅ Respond promptly to surveyor information requests
  • ✅ Review draft Awards carefully before finalization
  • ✅ Ensure contractors receive and understand Award requirements
  • ✅ Maintain professional communication with all parties

Looking Ahead

The party wall landscape continues to evolve with emerging project types, particularly EV infrastructure installations and net-zero retrofits that are reshaping surveyor demand in 2026[5]. Property owners who understand the appointment process, select qualified professionals, and maintain systematic approaches will navigate these requirements efficiently, keeping projects on schedule and within budget.

Whether you're a building owner planning works or an adjoining owner responding to neighbor notices, professional surveyor appointment provides the framework for protecting property interests while facilitating necessary construction. The modest investment in quality surveying prevents costly disputes, preserves neighbor relationships, and ensures compliance with statutory requirements.

Start your surveyor selection process early, prioritize independence and qualifications, and maintain professional communication throughout. These practices transform party wall procedures from potential obstacles into manageable administrative steps that protect all parties' interests.


References

[1] Party Wall Agreement – https://hoa.org.uk/advice/guides-for-homeowners/i-am-improving/party-wall-agreement/

[2] A Reasonable Party Wall Guide – https://howorth.uk/2026/03/04/a-reasonable-party-wall-guide/

[5] Party Wall Surveys For Ev Infrastructure Retrofits Compliance Amid 2026 Net Zero Mandates And Neighbour Disputes – https://nottinghillsurveyors.com/blog/party-wall-surveys-for-ev-infrastructure-retrofits-compliance-amid-2026-net-zero-mandates-and-neighbour-disputes

Scroll to Top
