A viral short-form video circulating in 2026 shows a homeowner standing in front of a stalled building site — no workers, no progress, just a half-dug foundation — explaining that the entire project ground to a halt because the party wall process had not been started in time. The comments section filled with thousands of people sharing the same story. This is not a rare edge case. It is one of the most common and most avoidable reasons that home extension projects in the UK run over schedule and over budget.
Understanding why you must start your party wall notice and agreement embarrassingly early before extensions is not just useful advice — it is the difference between a project that runs smoothly and one that costs you thousands in delays, legal exposure, and neighbour disputes.
Key Takeaways
- The law requires a minimum notice period of one to two months before work can legally begin, depending on the type of work.
- Neighbours have a 14-day window to respond, and a dispute can add weeks or months to the process.
- You are legally permitted to serve notice up to 12 months in advance — and doing so early is strongly recommended.
- Failing to serve notice does not make the work illegal, but it removes your legal protections and exposes you to injunctions and civil claims.
- Starting the party wall process the moment your extension plans are confirmed is the single most effective way to protect your project timeline.
The Legal Minimum Is Not a Safe Target
The Party Wall etc. Act 1996 sets out specific minimum notice periods that building owners must observe before starting work. These are not suggestions — they are legal requirements.
| Type of Work | Minimum Notice Period |
|---|---|
| Work on or to a party wall or structure | 2 months |
| New building at or astride the boundary | 1 month |
| Excavation near a neighbouring building | 1 month |
Most homeowners planning a rear extension will trigger the two-month notice requirement because the work typically involves a shared wall or a wall that forms part of the boundary structure [4].
Here is the critical point: the two-month period does not begin when you decide to start building. It begins only after a valid notice has been properly served on every adjoining owner. If the notice is defective — wrong format, missing information, served on the wrong person — the clock does not start. You may need to re-serve, and the entire countdown resets.
"The notice period is a legal minimum, not a project management buffer. Treating it as one is a costly mistake."
Many homeowners make the error of treating the legal minimum as a planning target. They finalise drawings, obtain planning permission, hire a contractor, and only then think about the party wall process. By that point, they are already behind.
According to official government guidance, the notice must be served before work begins, and neighbours must be given adequate time to respond [4]. The Federation of Master Builders similarly advises homeowners to begin the party wall process well in advance of their intended start date [2].
Why the Process Almost Always Takes Longer Than the Minimum
Understanding why you must start your party wall notice and agreement embarrassingly early before extensions becomes clearer when you map out every stage the process can involve — not just the notice period itself.
Stage 1: Serving the Notice
Before a notice can be served, you need to know exactly what work is planned, which boundaries and walls are affected, and who the adjoining owners are. For a typical London terraced house extension, this might involve two or three neighbours. Each one must receive a separate, valid notice. Understanding what a party structure notice is and how to serve it correctly is an essential first step.
Stage 2: The Neighbour's Response Window
After the notice is served, each adjoining owner has 14 days to respond. They can:
- Consent — work can proceed after the notice period expires
- Dissent and agree to a single agreed surveyor — the process moves to a party wall award
- Dissent and appoint their own surveyor — a two-surveyor or three-surveyor process begins
- Fail to respond at all — after 14 days of silence, a deemed dispute is triggered automatically [1]
A deemed dispute is not a resolution. It is the start of a formal dispute process that requires surveyors to be appointed. This alone can add two to four weeks before any substantive progress is made [3].
Stage 3: Appointing Surveyors and Preparing the Award
If a dispute arises — whether through active dissent or a deemed dispute — a party wall award must be prepared before work can begin. This is a legal document that sets out the rights and obligations of both parties, the manner in which the work is to be carried out, and any protective measures for the adjoining property.
Preparing a party wall award takes time. Surveyors must inspect the properties, exchange drafts, agree on terms, and execute the final document. In straightforward cases, this might take three to four weeks. In contested cases, it can take considerably longer [3].

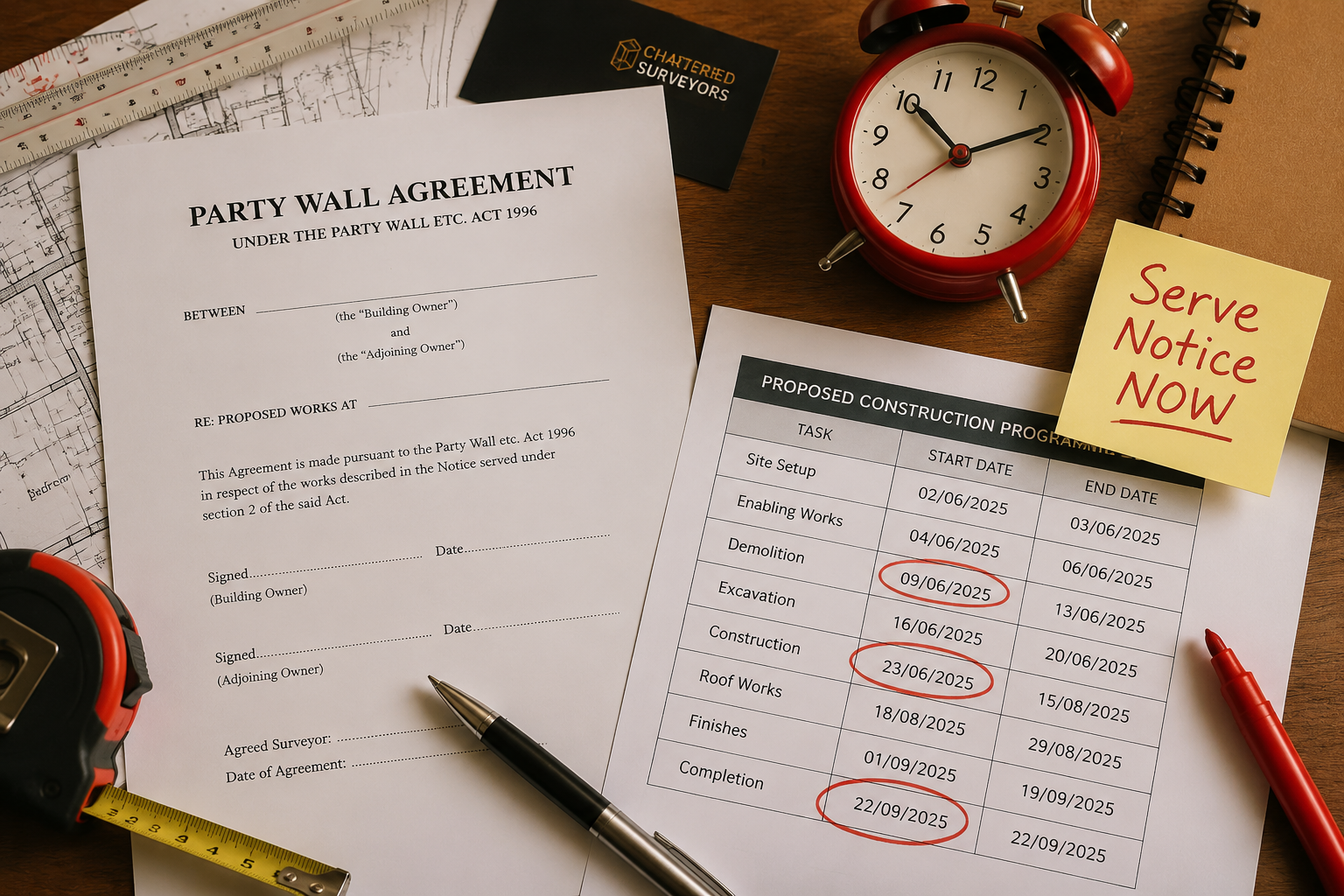

Stage 4: Schedule of Condition
Before work starts, it is standard practice — and often required under the award — to carry out a schedule of condition. This is a detailed photographic and written record of the adjoining property's condition before any work begins. It protects both parties in the event of a damage claim later. Arranging and completing this adds further time.
Add it all together and the realistic minimum timeline from first notice to legal commencement of work is often 10 to 14 weeks — not the bare two months the law requires.
The Real Cost of Starting Too Late
A Reddit thread from 2026 documents a homeowner whose neighbour served a party wall notice just 17 days before planned works were due to begin [9]. The thread attracted hundreds of responses from people who had experienced similar situations — either as the building owner scrambling to comply or as the adjoining owner suddenly facing construction with almost no notice.
The consequences of starting too late fall into several categories:
1. Project delays
Contractors cannot legally begin work until the party wall process is resolved. If a contractor is booked and the award is not in place, the start date must be pushed back. Rescheduling a contractor can mean waiting weeks or months for a new slot, particularly in busy urban areas.
2. Financial penalties
Delay clauses in building contracts can make the building owner liable for costs if the project cannot start on the agreed date. These costs can be significant [2].
3. Loss of legal protection
Proceeding without a valid notice or award does not make the work impossible, but it strips the building owner of the protections the Act provides. Adjoining owners can apply for an injunction to stop the works entirely [10]. They can also pursue civil claims for any damage caused, without the structured framework the Act would otherwise provide.
4. Damaged neighbour relations
Extensions are stressful enough. Rushing the party wall process, or bypassing it altogether, is one of the fastest ways to create lasting hostility with neighbours — which can complicate everything from access agreements to future property sales.
You Can Serve Notice Up to 12 Months in Advance — Use That Window
One of the most underused provisions of the Party Wall etc. Act 1996 is that notices can be served up to 12 months before the planned start of work [4]. There is no legal disadvantage to serving early. The notice remains valid for 12 months from the date of service.
This means the moment a homeowner decides they want to build an extension — even before planning permission is granted, even before a contractor is appointed — they can begin the party wall process. Doing so creates a substantial buffer against every source of delay described above.
Official guidance now explicitly recommends serving notice "as soon as possible" rather than waiting until the project is ready to begin [4]. Trade bodies echo this advice [2].
For homeowners who are unsure whether their planned work even triggers the Act, reviewing the types of party wall works that require notice is a sensible first step. Many are surprised to find that relatively modest works — including excavations within three or six metres of a neighbouring structure — fall within the Act's scope.
What Happens If Plans Change After Notice Is Served?
A common concern is that serving notice early locks the homeowner into a specific set of plans. In practice, if the scope of work changes materially, a new or amended notice may need to be served. However, this is far preferable to the alternative: discovering that the process has not been started at all when the contractor is ready to begin.
If plans are still being finalised, it is worth discussing the situation with a qualified party wall surveyor before serving notice, to ensure the notice accurately reflects the intended works.
Practical Steps to Start the Process the Right Way
Why you must start your party wall notice and agreement embarrassingly early before extensions is clear — but knowing how to begin is equally important.
Step 1: Identify all affected neighbours
Determine which adjoining properties share a wall, boundary, or are within the excavation zones defined by the Act. This includes properties to the side, rear, and in some cases directly below (in the case of basement works).
Step 2: Establish whether consent is likely
Some neighbours will consent immediately, which simplifies the process significantly. Understanding how a party wall agreement can work without a surveyor in cases of straightforward consent can save time and money.
Step 3: Serve valid notices
Use the correct notice format for each type of work. A sample party wall agreement template can help ensure notices are properly structured. For complex projects, engaging a surveyor to serve notices on your behalf reduces the risk of defective service.
Step 4: Respond promptly to any dissent
If a neighbour dissents, appoint a surveyor without delay. Every day of inaction at this stage extends the overall timeline.
Step 5: Factor the process into your project programme
Share the party wall timeline with your architect and contractor from the outset. Build the notice period, response window, and award preparation into the project programme — not as an afterthought, but as a fixed constraint.
Understanding the costs of the party wall process upfront also allows for accurate budgeting and avoids surprises later in the project.
Common Misconceptions That Lead to Late Starts
"I'll sort the party wall stuff once planning permission comes through."
Planning permission and party wall consent are entirely separate processes. Waiting for one before starting the other is a guaranteed source of delay. The two processes can and should run in parallel.
"My neighbour is friendly — they'll just agree."
Friendly neighbours sometimes dissent, not out of hostility, but because they want the formal protections the Act provides. Even a consenting neighbour who later changes their mind can complicate matters. Formal process protects everyone.
"The builder said it's fine to start."
Builders are not party wall surveyors. Some contractors are unaware of or indifferent to the Act's requirements. The legal obligation rests with the building owner, not the contractor [10].
"It's a small job — the Act probably doesn't apply."
The Act applies to a wider range of works than most homeowners expect. Any work that involves or is adjacent to a shared wall, or involves excavation near a neighbouring property, is likely to trigger notice requirements. Checking early costs nothing; finding out too late can cost a great deal.
Conclusion
The party wall process is not an obstacle to building an extension — it is a legal framework designed to protect both building owners and their neighbours. The problem arises when homeowners treat it as a final administrative step rather than an early-stage priority.
The minimum notice periods set by law are just that: minimums. In practice, the full process — from serving notice to obtaining a party wall award and completing a schedule of condition — regularly takes three months or more. Serving notice the moment extension plans are confirmed, rather than waiting until the project is ready to begin, is the single most effective action a homeowner can take to protect their timeline.
Actionable next steps for 2026:
- Check whether your planned extension triggers the Party Wall etc. Act 1996 — do this before any other project planning.
- Identify all adjoining owners who must receive notice.
- Engage a qualified party wall surveyor early to advise on the correct notices and process.
- Serve notice as soon as plans are sufficiently developed — do not wait for planning permission or contractor appointment.
- Build the party wall timeline into your project programme from day one.
Starting embarrassingly early is not overcautious. It is the only approach that gives a home extension project the realistic chance of beginning on time.
References
[1] Party Wall Agreement – https://hoa.org.uk/advice/guides-for-homeowners/i-am-improving/party-wall-agreement/
[2] Party Wall Agreements What You Need To Know – https://www.fmb.org.uk/find-a-builder/ultimate-guides-to-home-renovation/party-wall-agreements-what-you-need-to-know.html
[3] Fast Party Wall Award – https://collier-stevens.co.uk/advice-hub/party-wall/fast-party-wall-award/
[4] When How Tell Them – https://www.gov.uk/party-walls-building-works/when-how-tell-them
[9] Neighbour Sent A Party Wall Notice 17 Days Before – https://www.reddit.com/r/HousingUK/comments/1r7yno3/neighbour_sent_a_party_wall_notice_17_days_before/
[10] Party Wall Agreement Never Sought – https://www.property118.com/party-wall-agreement-never-sought/
