Party Wall Act 1996 in Plain English: A Clause‑by‑Clause Guide for Homeowners Planning Works

Around one in five UK homeowners who carry out building work near a shared boundary unknowingly break the law — not because they are reckless, but because the Party Wall etc. Act 1996 is written in dense legal language that most people simply do not understand. This guide cuts through that complexity. The Party Wall Act 1996 in Plain English: A Clause‑by‑Clause Guide for Homeowners Planning Works breaks down every key section of the legislation into everyday language, with real-world examples from loft conversions, rear extensions, and basement digs — so you know exactly when the law applies to you and what to do next.

Wide-angle editorial photograph of a UK homeowner and a professional party wall surveyor standing at a shared brick boundary


Key Takeaways 📋

  • The Party Wall etc. Act 1996 legally requires you to notify neighbours before carrying out certain types of building work near a shared wall, boundary, or structure.
  • Three distinct types of notice exist — and serving the wrong one (or none at all) can halt your project and expose you to legal liability.
  • Neighbours have 14 days to respond to a notice; silence is treated as a dispute, not consent.
  • A Party Wall Award (a formal agreement drawn up by a surveyor) is the mechanism that protects both parties and keeps work moving.
  • You do not always need a solicitor — but understanding the Act's clauses is essential before you pick up a shovel.

What Is the Party Wall etc. Act 1996? The Plain-English Overview

The Party Wall etc. Act 1996 is a piece of UK legislation that governs building work carried out on or near shared walls, floors, and boundaries between neighbouring properties. It applies in England and Wales only. Scotland and Northern Ireland have separate legal frameworks.

The Act was designed to do three things:

  1. Protect building owners — giving them the right to carry out necessary works.
  2. Protect adjoining owners — ensuring neighbours are informed and compensated if their property is damaged.
  3. Provide a dispute resolution mechanism — so disagreements are settled by surveyors, not courts.

💡 Pull Quote: "The Act does not stop you building — it simply requires you to follow a process that protects everyone involved."

The legislation covers three broad categories of work, each governed by a specific section (or "clause") of the Act. Understanding which clause applies to your project is the first critical step.

For a full overview of how the legislation works in practice, see this detailed guide on the Party Wall etc. Act 1996.


The Three Core Sections of the Act — Decoded

Flat-lay overhead shot of a wooden desk with the Party Wall etc. Act 1996 legal document open to key sections, surrounded by

Section 1 — Building a New Wall on or at the Boundary Line

What it covers: Constructing a new wall that sits astride (straddles) the boundary line between two properties, or building a wall entirely on your own land but right up to the boundary.

Real-world example: You want to build a garden wall or a new garage wall along the line where your land meets your neighbour's. If the wall will sit on the boundary itself — half on each side — Section 1 applies.

What you must do:

  • Serve a Line of Junction Notice at least one month before work begins.
  • The notice must state your intention to build and whether the wall will straddle the boundary or sit entirely on your side.

What happens next:

  • If your neighbour consents, you can build astride the boundary and share the cost proportionately.
  • If your neighbour refuses, you must build entirely on your own land, set back from the boundary.

Key point: A wall built entirely on your own land does not technically become a party wall under Section 1 — it remains your wall alone. The Act still requires the notice, but your neighbour has no ownership rights over it.


Section 2 — Works to an Existing Party Wall or Structure

This is the section most homeowners encounter. Section 2 lists 14 specific types of work that require a Party Structure Notice. These are the works most likely to affect a shared wall or structure.

The most common Section 2 works include:

Work Type Common Example
Cutting into a party wall Installing a steel beam (RSJ) for a rear extension
Raising a party wall Adding a storey or loft conversion
Underpinning a party wall Basement conversion or excavation
Demolishing and rebuilding a party wall Structural renovation
Weatherproofing a party wall Applying flashing or DPC
Inserting a damp-proof course Damp-proofing shared walls

Real-world example — Loft Conversion: When you convert a loft in a semi-detached or terraced house, you almost certainly need to cut into the party wall to install steel beams. This triggers Section 2. A Party Structure Notice must be served at least two months before work starts.

Real-world example — Rear Extension: Knocking through to an existing party wall to create an open-plan kitchen-diner, or building up against the shared wall, requires a Section 2 notice.

Notice period: Two months minimum before the proposed start date.

Neighbour's response options:

  • Consent — work can proceed without a formal award.
  • Dissent — a dispute is deemed to have arisen, and surveyors must be appointed.
  • 🔇 No response within 14 days — automatically treated as dissent.

For a comprehensive breakdown of party wall notices — what they are and how to respond, including template letters and timelines, that resource is worth bookmarking.


Section 6 — Excavation Near a Neighbouring Building

Section 6 is the clause that catches many homeowners off guard — particularly those planning basement conversions or deep foundations.

What it covers: Any excavation within:

  • 3 metres of a neighbouring building or structure, where the excavation goes deeper than the neighbour's foundations.
  • 6 metres of a neighbouring building, where the excavation cuts a line drawn downward at 45° from the bottom of the neighbour's foundations.

Real-world example — Basement Conversion: Digging out a basement beneath a terraced house almost always falls within 3 metres of the adjoining property. If the dig goes deeper than the neighbour's footings, Section 6 is triggered automatically.

Notice period: One month minimum before work begins.

What the notice must include:

  • Plans and sections showing the depth and location of the proposed excavation.
  • Details of any underpinning or strengthening work proposed.

⚠️ Important: Section 6 applies even if you are not touching the party wall at all. The proximity of the excavation to the neighbour's foundations is what matters.


What Happens After a Notice Is Served?

Understanding the post-notice process is just as important as knowing which notice to serve. Here is the step-by-step flow:

Step 1 — Serve the correct notice (with the right notice period for the relevant section).

Step 2 — Neighbour responds within 14 days:

  • Consent given → Work can proceed. No surveyor needed (though a Schedule of Condition is still recommended).
  • Dissent given or no response → A dispute is deemed to exist.

Step 3 — Appoint surveyor(s):

  • Each party can appoint their own surveyor (most common).
  • Both parties can agree to use a single Agreed Surveyor.

Step 4 — Surveyors produce a Party Wall Award:
A Party Wall Award is a legally binding document that sets out:

  • The work to be carried out.
  • The hours during which work may take place.
  • How any damage will be assessed and compensated.
  • A Schedule of Condition of the adjoining property before work begins.

Step 5 — Work begins and is monitored in accordance with the Award.

For a detailed look at what a Party Wall Award contains, the party wall contract template and guide on party wall awards is an excellent reference.


Common Works and Which Clauses They Trigger

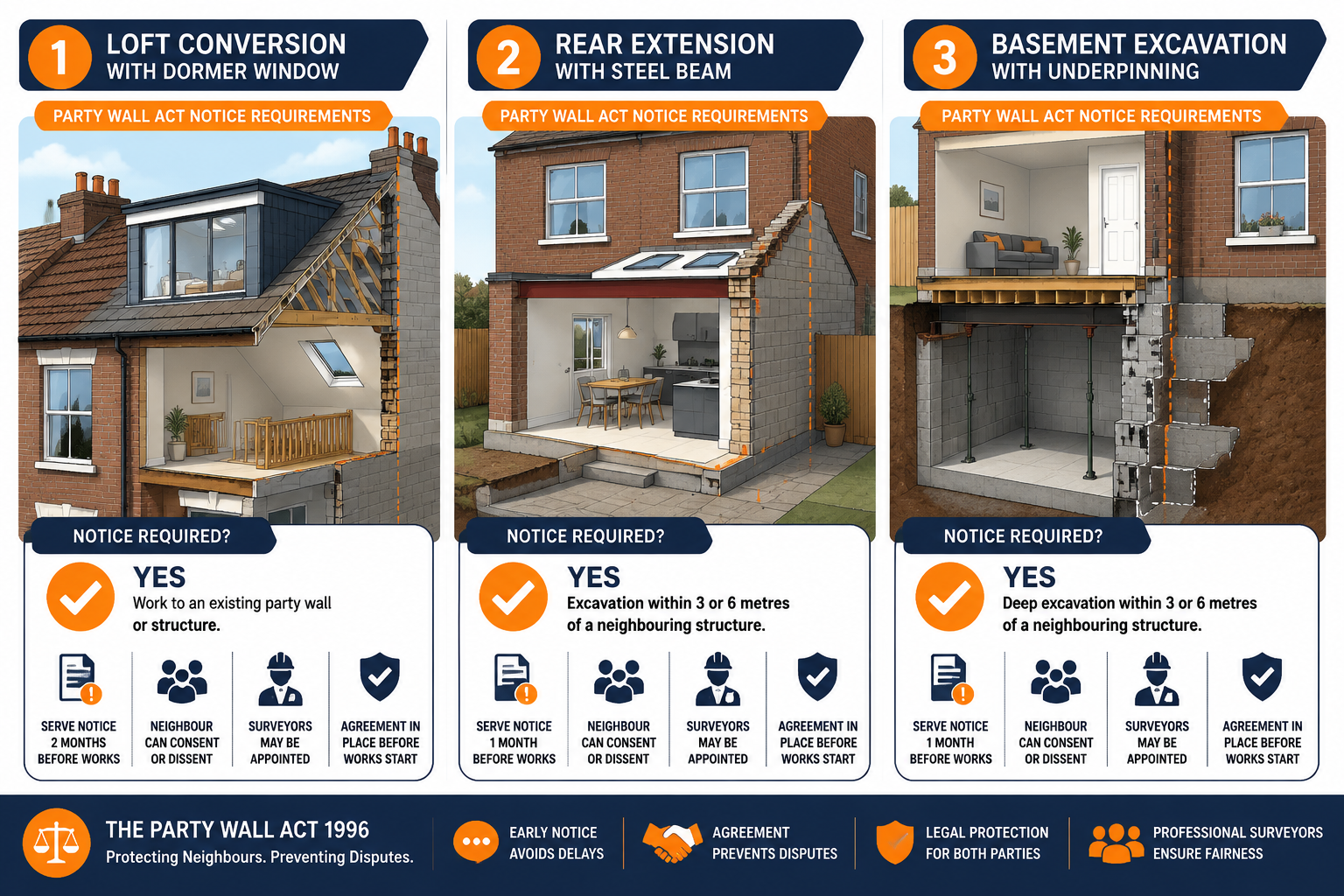

Split-screen infographic-style illustration showing three common UK home improvement scenarios side by side: a loft

This is where the Party Wall Act 1996 in Plain English guidance becomes most practical. Here is a quick-reference breakdown of common home improvement projects:

🏠 Loft Conversion

  • Section 2 — cutting into party wall for steel beams.
  • Notice required: Party Structure Notice (2 months).
  • Section 6 may apply if new foundations are needed close to the boundary.

🧱 Rear Extension

  • Section 2 — working on or building up to the party wall.
  • Section 6 — if new foundations are within 3m or 6m of neighbour's building.
  • Notice required: Party Structure Notice (2 months) + Three Metre/Six Metre Notice (1 month).

🏚️ Basement Conversion

  • Section 6 — almost always triggered due to excavation depth and proximity.
  • Section 2 — if underpinning the party wall itself.
  • Notice required: Three Metre/Six Metre Notice (1 month) + potentially Party Structure Notice (2 months).

🪟 Removing a Chimney Breast

  • Section 2 — if the chimney breast is part of a party wall or party structure.
  • Notice required: Party Structure Notice (2 months).

🌿 Garden Wall Construction

  • Section 1 — if building on or at the boundary line.
  • Notice required: Line of Junction Notice (1 month).

For a full list of types of party wall works that fall under the Act, that resource provides an authoritative breakdown.


Rights and Responsibilities — What the Act Actually Gives You

The Act is not just a list of obligations. It also grants specific rights to building owners (those carrying out work) that many homeowners do not realise they have.

Rights of the Building Owner (You, If Carrying Out Work)

  • The right to carry out the works listed in Section 2, even if your neighbour objects — provided the correct process is followed.
  • The right to enter the adjoining property (with 14 days' notice) to carry out works or inspections.
  • The right to underpin or strengthen the adjoining owner's foundations where necessary for your works.

Rights of the Adjoining Owner (Your Neighbour)

  • The right to appoint a surveyor at your expense (as the building owner, you typically pay for both surveyors).
  • The right to have a Schedule of Condition prepared before work starts — documenting the state of their property.
  • The right to compensation for any damage caused by your works.
  • The right to dispute the Party Wall Award in a county court within 14 days of it being served.

If you are a neighbour receiving a notice, the adjoining owners' guide explains your rights and options in detail.


Boundary Walls vs. Party Walls — A Critical Distinction

One of the most common points of confusion is the difference between a party wall and a boundary wall. They are not the same thing, and the Act treats them differently.

Feature Party Wall Boundary/Party Fence Wall
Position Sits astride the boundary Sits on the boundary but is not part of a building
Ownership Shared between both owners May be shared or owned by one party
Act coverage Sections 1, 2, and 6 may apply Section 1 applies for new construction
Common example Shared wall between semis Garden fence or standalone garden wall

For a deeper dive into these definitions, the guide on boundary wall rules and the difference between party fence walls and boundary walls is essential reading.


Do You Always Need a Surveyor?

Not always — but it depends on your neighbour's response.

When a surveyor is NOT required:

  • Your neighbour gives written consent to the notice within 14 days.
  • The works are minor and your neighbour is happy to proceed informally.

When a surveyor IS required:

  • Your neighbour dissents or fails to respond within 14 days.
  • The works are complex or high-value.
  • There is any existing dispute or tension between you and your neighbour.

Even when consent is given, many professionals recommend a Schedule of Condition — a photographic and written record of the neighbour's property before work starts. This protects both parties if damage claims arise later.

It is also worth knowing that you can sometimes reach a party wall agreement without a surveyor — but only in specific circumstances and with careful documentation.


What Happens If You Ignore the Act?

Failing to serve the correct notices is not a criminal offence — but the consequences can be severe:

  • Injunctions: Your neighbour can apply to court to stop your works immediately.
  • Damages: You may be liable for any damage caused, with no legal framework to limit your exposure.
  • Retrospective awards: Surveyors can be appointed after work has started, but this is more expensive and contentious.
  • Mortgage and sale issues: Conveyancers routinely ask for Party Wall Awards on sale — missing paperwork can delay or derail a property sale.

⚠️ Pull Quote: "An injunction can halt a building site within 24 hours. The cost of serving a notice correctly is always less than the cost of a legal dispute."


Costs — Who Pays and How Much?

In most cases, the building owner (the person carrying out the works) pays:

  • Their own surveyor's fees.
  • The adjoining owner's surveyor's fees (if appointed separately).
  • The cost of preparing the Party Wall Award.
  • Any compensation for damage caused.

Typical costs in 2026:

  • Agreed surveyor (single surveyor for both parties): £700–£1,200 per Award.
  • Two surveyors (one each): £1,500–£2,500+ depending on complexity.
  • Third surveyor (if the two surveyors disagree): Additional fees apply.

For practical strategies on how to keep party wall costs down, that guide offers actionable tips including how to encourage neighbours to consent rather than dissent.


Conclusion: Your Action Plan Before Work Starts ✅

The Party Wall Act 1996 in Plain English: A Clause‑by‑Clause Guide for Homeowners Planning Works boils down to one core principle: inform your neighbours, follow the process, and protect everyone involved — including yourself.

Here are your actionable next steps before any building work begins:

  1. Identify which section(s) apply — use the clause breakdown above to check whether your project triggers Section 1, 2, or 6 (or a combination).
  2. Check the notice period — allow at least one or two months before your planned start date, depending on the section.
  3. Serve the correct written notice — include all required details (description of works, start date, plans if applicable).
  4. Wait for your neighbour's response — 14 days for consent or dissent.
  5. Appoint a surveyor if needed — and consider an Agreed Surveyor to keep costs manageable.
  6. Commission a Schedule of Condition — even when consent is given, this protects both parties.
  7. Keep all paperwork — Party Wall Awards, notices, and consents are essential documents for future property sales.

The Act exists to make building work fairer and safer for everyone. Understanding it is not just a legal obligation — it is good neighbourly practice.
